Spirited Energy

Manitoba doesn’t need another gas plant

It needs heat that works twice. Spirited Energy 2.0 — soil, water, energy — same dual ledgers as the master report.

1 / 18 · 12 Aug 2026

Spirited Energy

The cold morning test

5,096 MW

23 January 2024 peak PD. Brandon gas: outages/deratings in 3 of 10 highest winter events PD.

2 / 18

Spirited Energy

The choice

Gas

$3.0B · 750 MW nameplate

20-yr $4.5–6.9B

Hybrid

$1.95B gross · dual ledger

20-yr $1.5–1.8B

3 / 18

Spirited Energy

Dual ledger explained

MWth never sums into MW electric. Effluent stage 50 MWth → +38 MW net; compute reject (95 MWth) gated, load netted first.

Retired composite 895 MW is forbidden.

4 / 18

Spirited Energy

Scenarios vs shortfall

  • Conservative 413 MW
  • Reference 688 MW (+88)
  • Full 788 MW (+188)
  • Shortfall 600 MW
5 / 18

Spirited Energy

Delivered $/kW

Pass gate: reference gross $2,834/kW beats gas nameplate $4,000/kW — no ITC, no derate assumed. Net $2,180; derate sensitivity $5,714.

6 / 18

Spirited Energy

Twenty-year bands

Non-overlapping. Savings $2.7–5.4B.

7 / 18

Spirited Energy

Reliability / ELCC ask

3-of-10 is an audit request — not a flat 30% derate-as-fact.

8 / 18

Spirited Energy

Water honesty

Surplus floor ≥35%, first lien. Plan yield 130–320 t/yr against a ~3,050 t/yr external gap — no single measure closes it, ours included.

9 / 18

Spirited Energy

Zero eligible MW until gates

Heat customer · grid headroom · contracted buyer. Missing any gate → 0 MW.

10 / 18

Spirited Energy

Heat path + electric ledger

11 / 18

Spirited Energy

Winter load physics

12 / 18

Spirited Energy

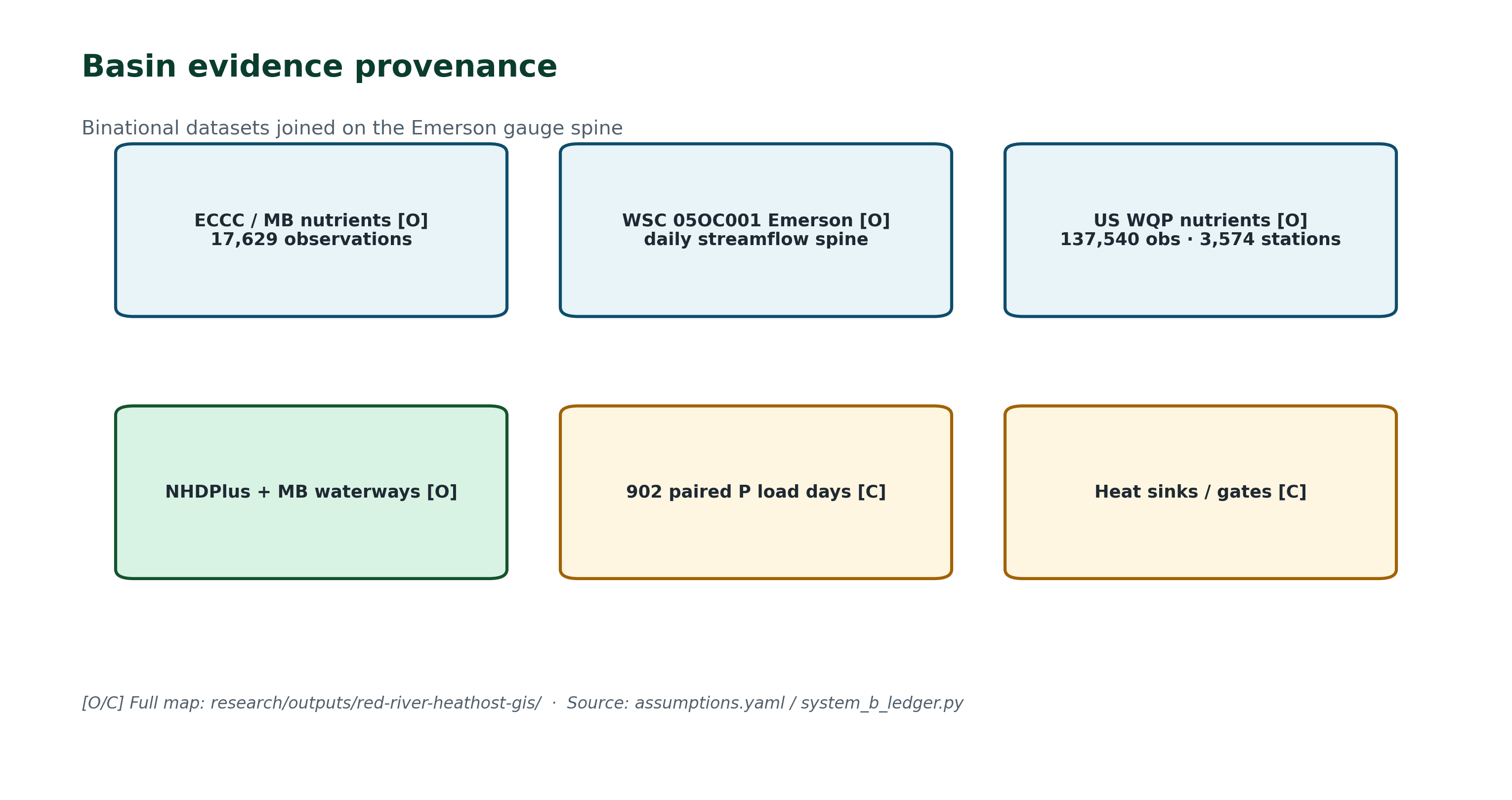

Basin evidence provenance

Emerson spine, binational nutrients, gates — metadata in docs/sources.md.

Basin evidence
13 / 18

Spirited Energy

Standards & auditability

14 / 18

Spirited Energy

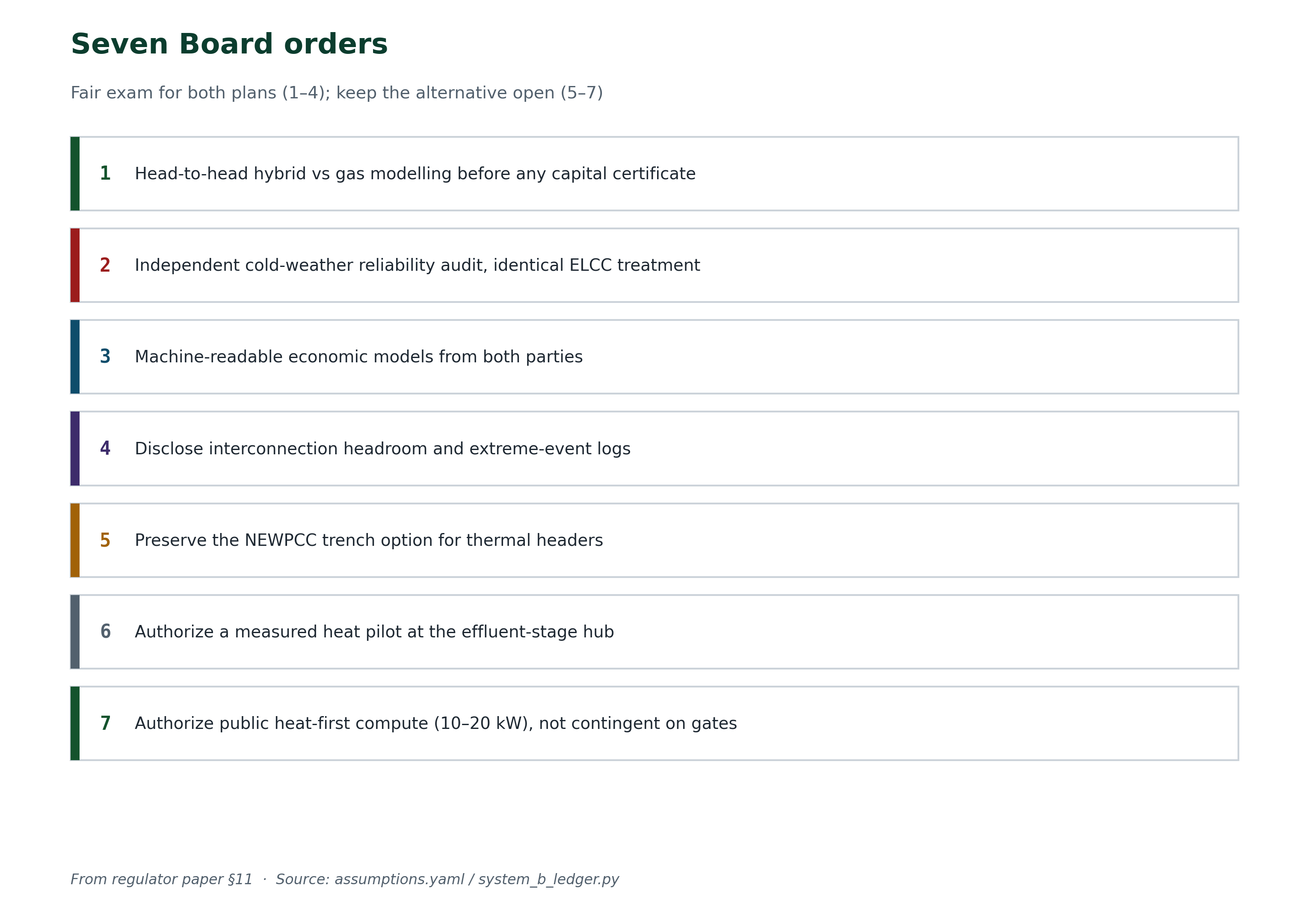

Seven Board orders

Seven Board orders 15 / 18

Spirited Energy

Stakeholder reply cards

16 / 18

Spirited Energy

Pilot ask

Authorize the effluent-stage heat pilot (Order 6) and public 10–20 kW heat-first compute (Order 7) on separate tracks, with public metered filings. Approving these costs little; approving $3.0B gas forecloses the alternative.

17 / 18

Spirited Energy

Same arithmetic. In public. Before the concrete.

Governing package: /report/ · Numbers: assumptions.yaml

18 / 18
